Site Establishment
- Access Points to working areas
- Access to Power
- Access to Water
Start Date
17 June 2025
Comments

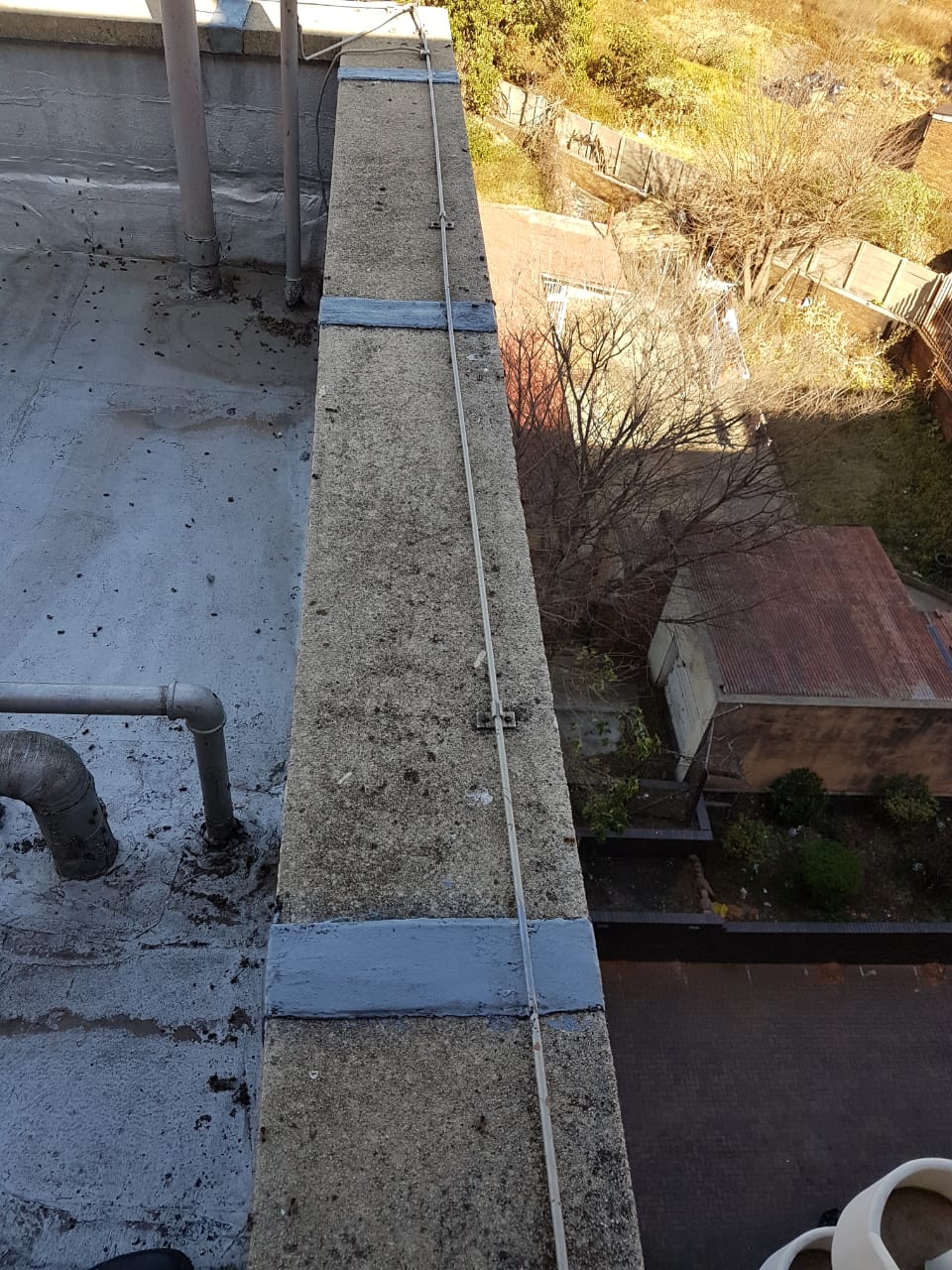

Complete sign in and walk through
Established water and power availability
Date completed
17 June 2025

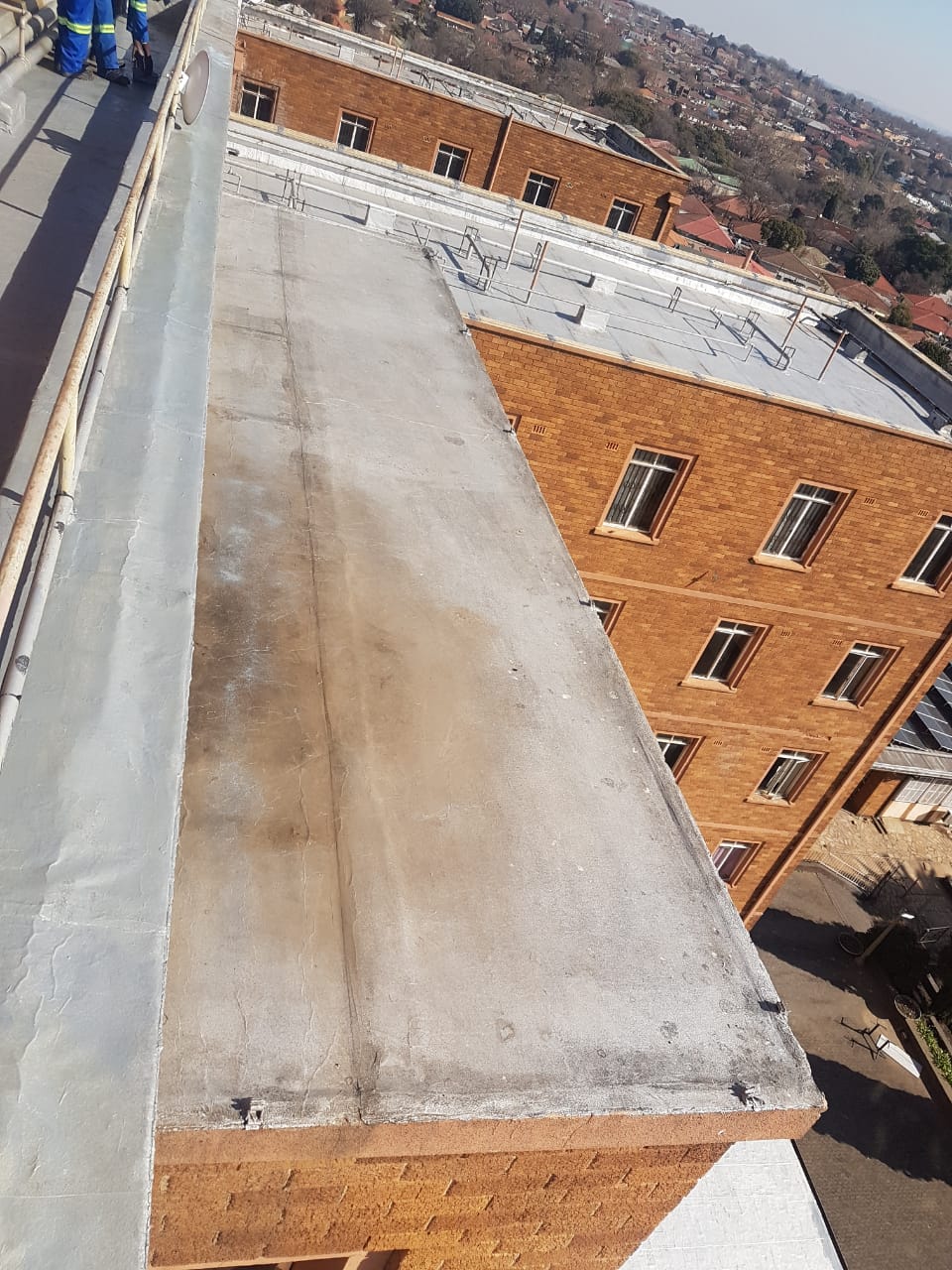

Cleaning

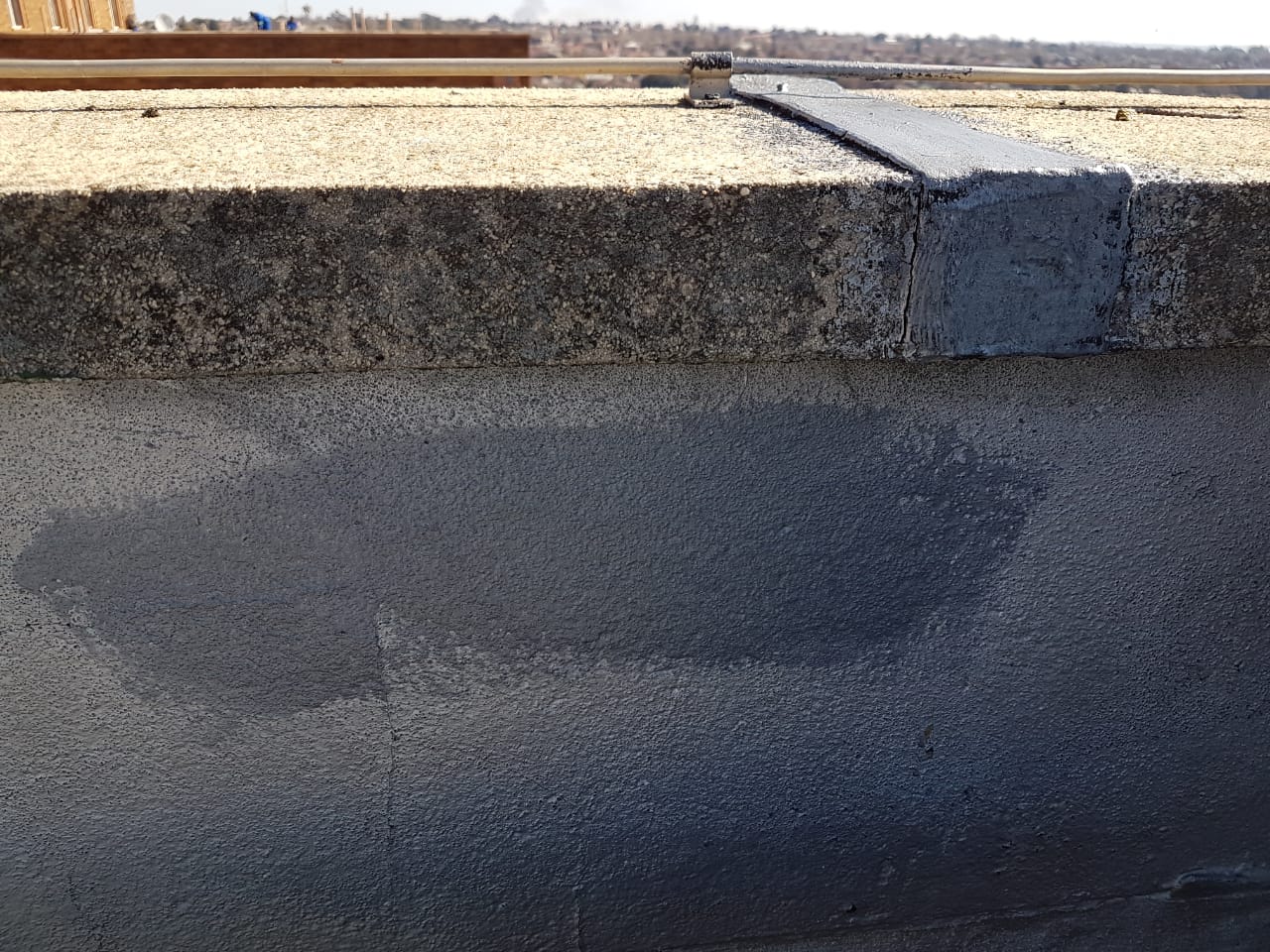

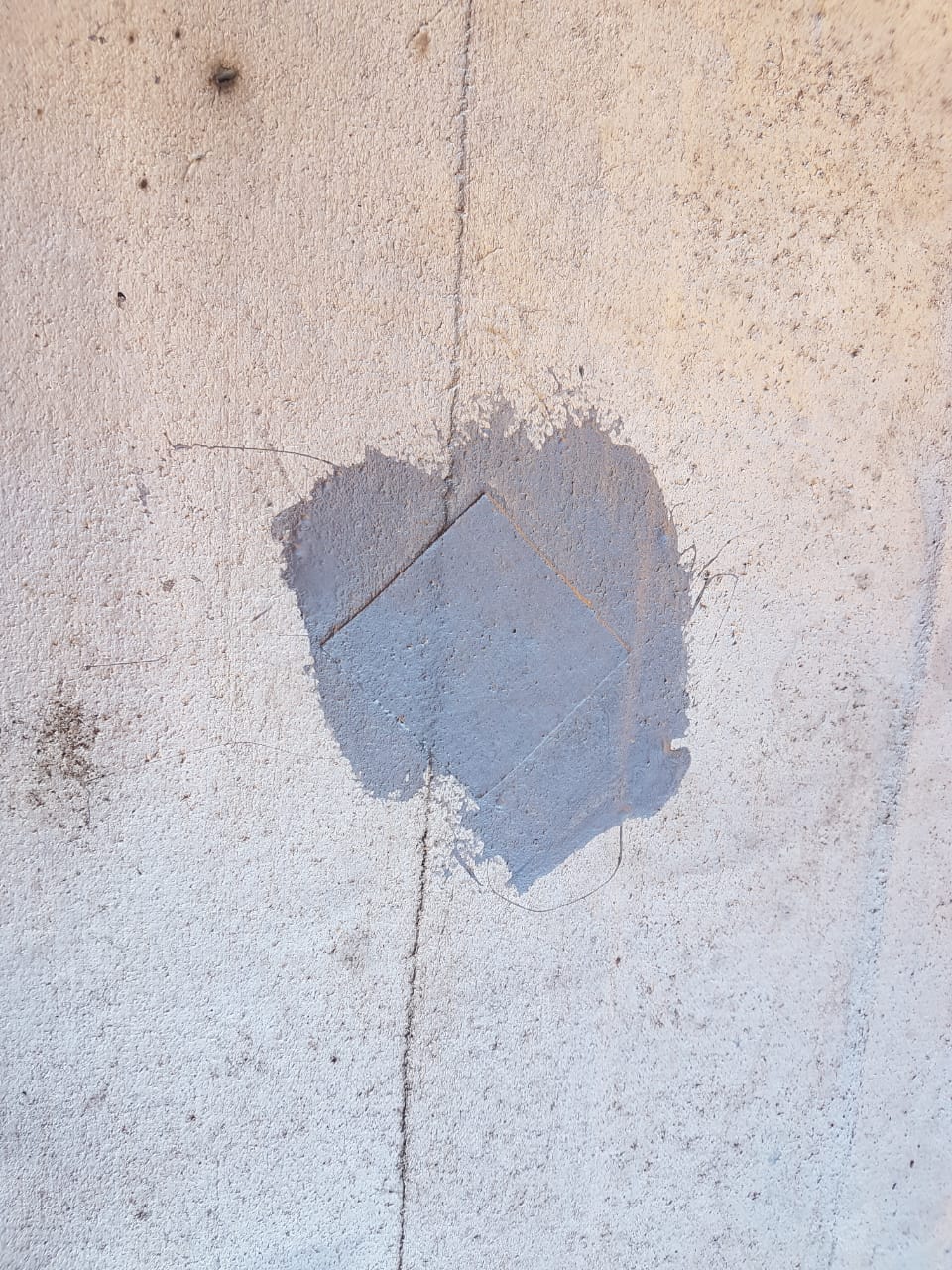

- Check, repair cracks, tears and breaks of torchon
- Power wash roof
Start date
17 – 20 June 2025
Comments
Cleaning – bees encountered on roof ACTION REQUIRED
Date completed
95% Completed awaiting removal of bee removal
Repairs

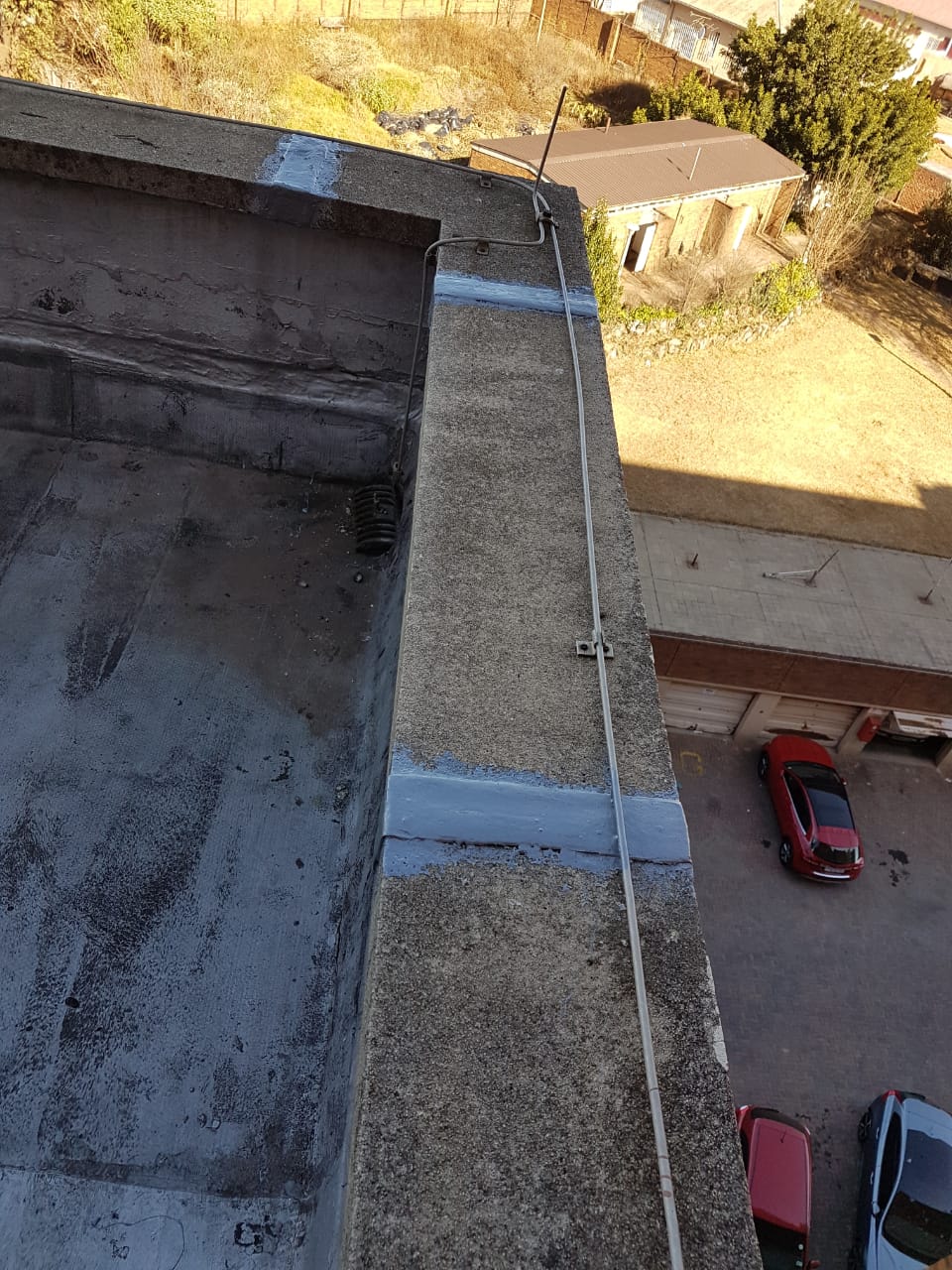

- Check, repair cracks, tears and breaks of torchon
- Power wash roof
Start date
23 – 25 June 2025
Comments
Repairs complete apart from the area of the bees
Date completed
24 June 2025

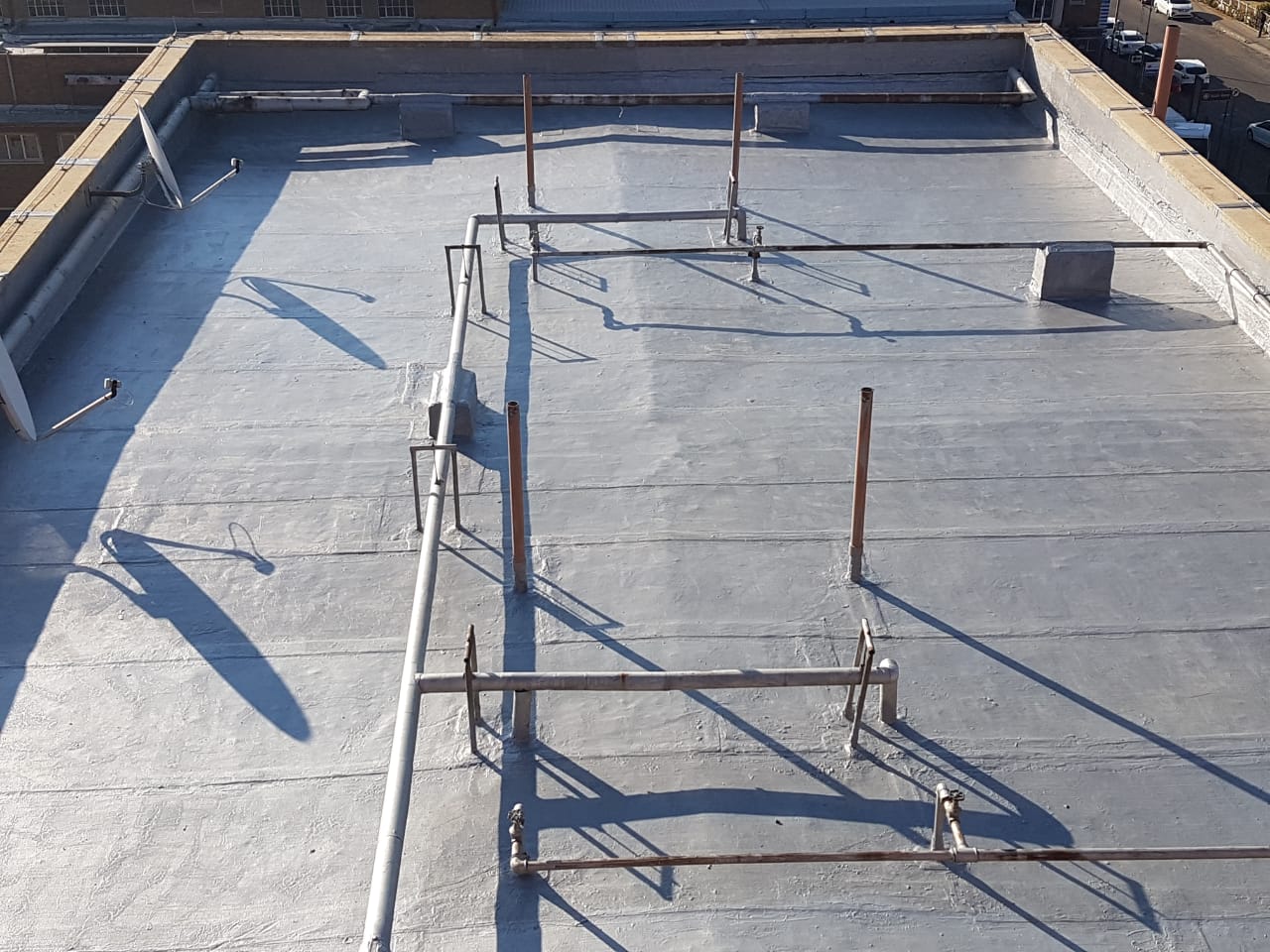

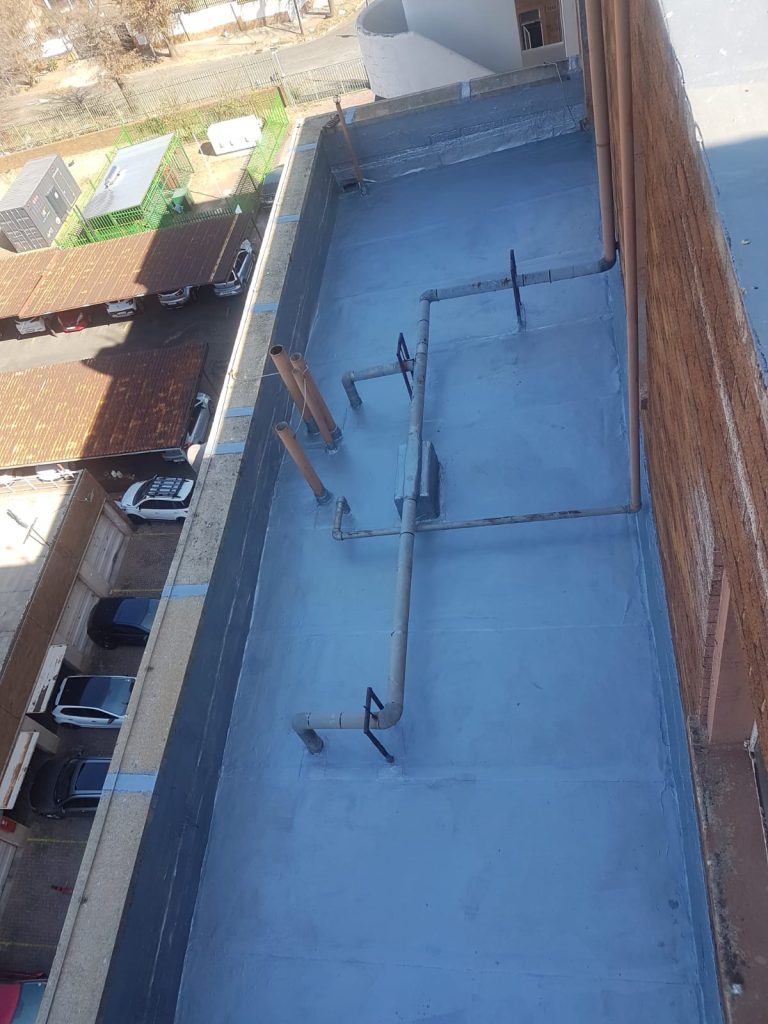

Sealing of roof
- 1st coat of sealer to be sprayed on
- 2nd coat of sealer to be sprayed on
- Hand painting of sealer in difficult to reach areas
Start Date
24-25 June 2025
26 – 30 June 2025
01 – 03 July 2025
Comments
Hand painting of of sealer
1st Coat
2nd Coat
Date completed
26 June 2025
Risk and Incidents

Bee Hive on roof (see layout)
Risk / Incident
18 June 2025
Bee Hive on roof (see layout)
30 June 2025
11 July 2025
14 July 2025
Comments
Log with hospital to remove the bee hive for us to proceed.
Spoke to Lichen from Ward 1
They have appointed a bee keeper to come and remove in July
Bees removed
Roof sealed
Person to Action
Marlan Naicker
Seelan Naicker to follow-up
Other findings

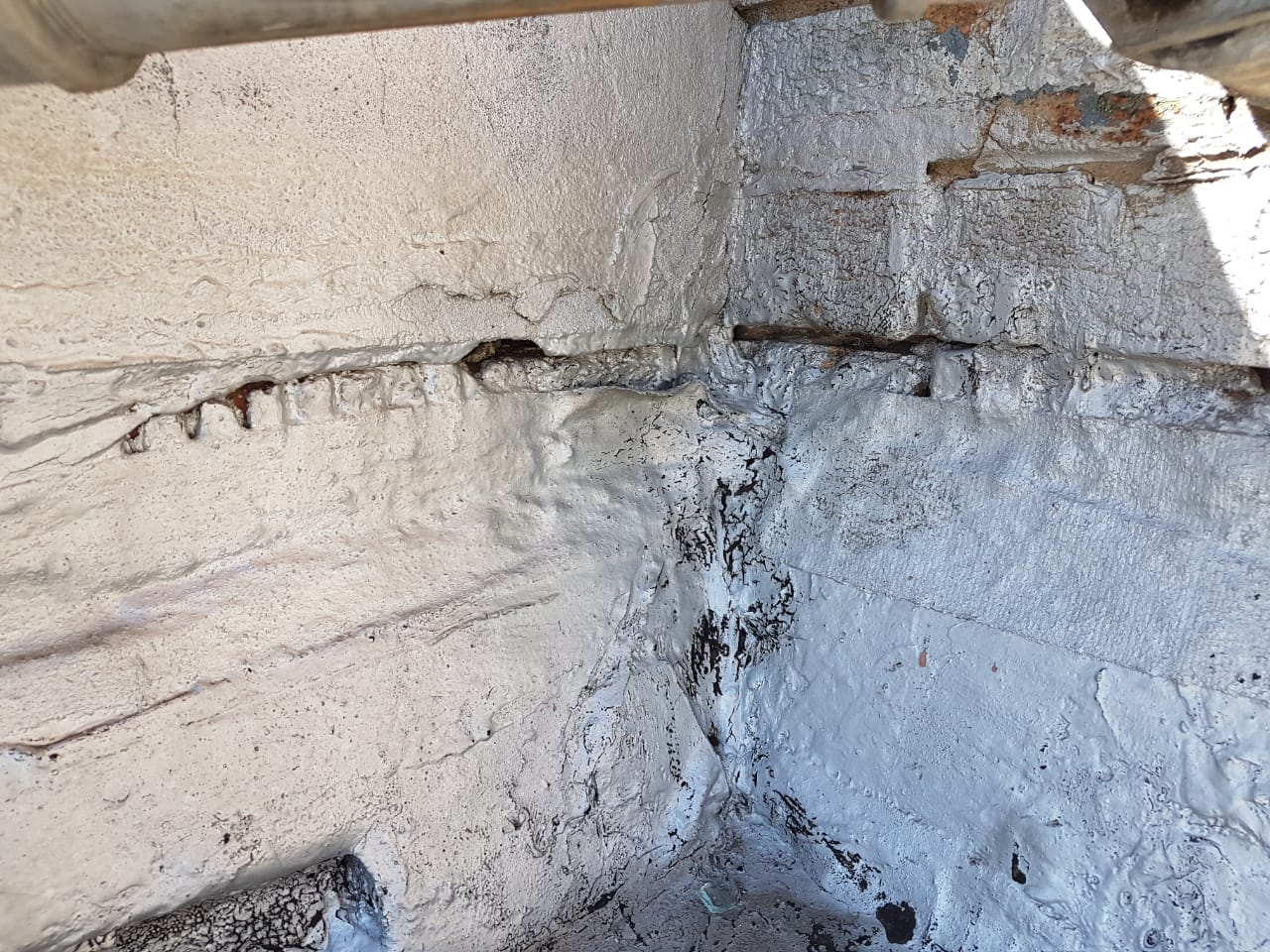

- Gutters rotten and needs to be repairs/replaced
Start Date
Comments
Date completed
