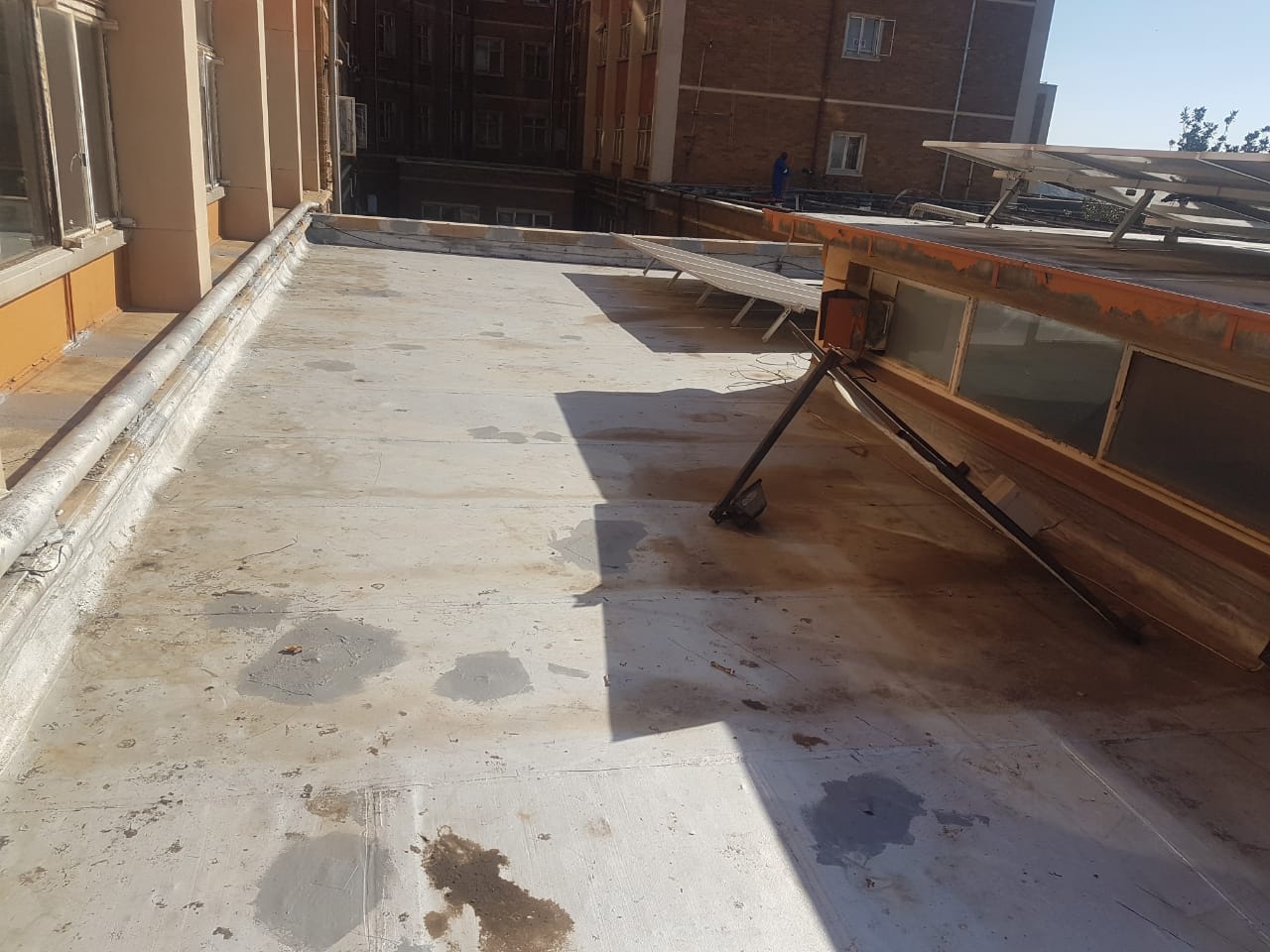

Site Establishment
- Access Points to working areas
- Access to Power
- Access to Water
Start date
17 June 2025
Comments
Date completed

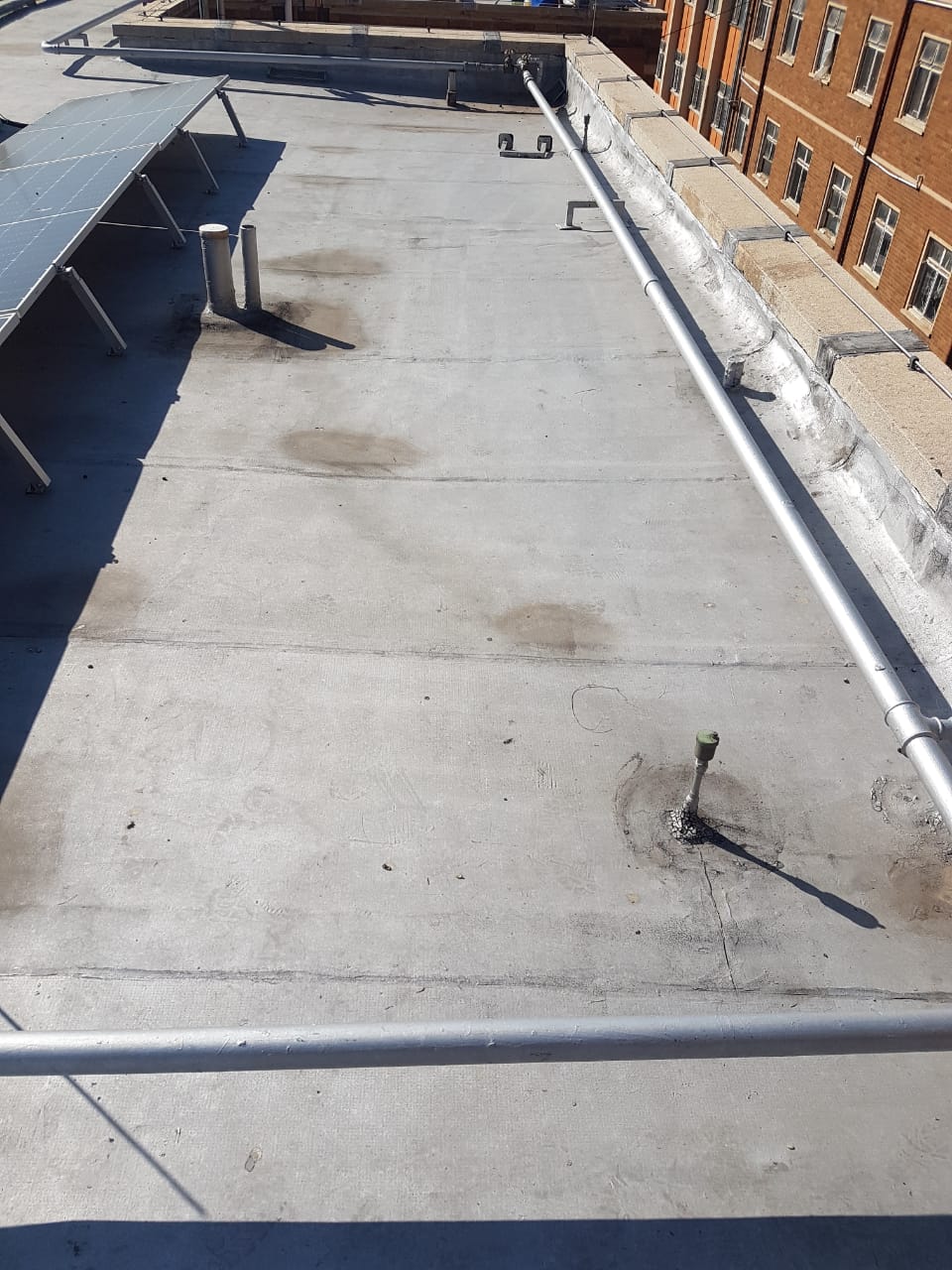

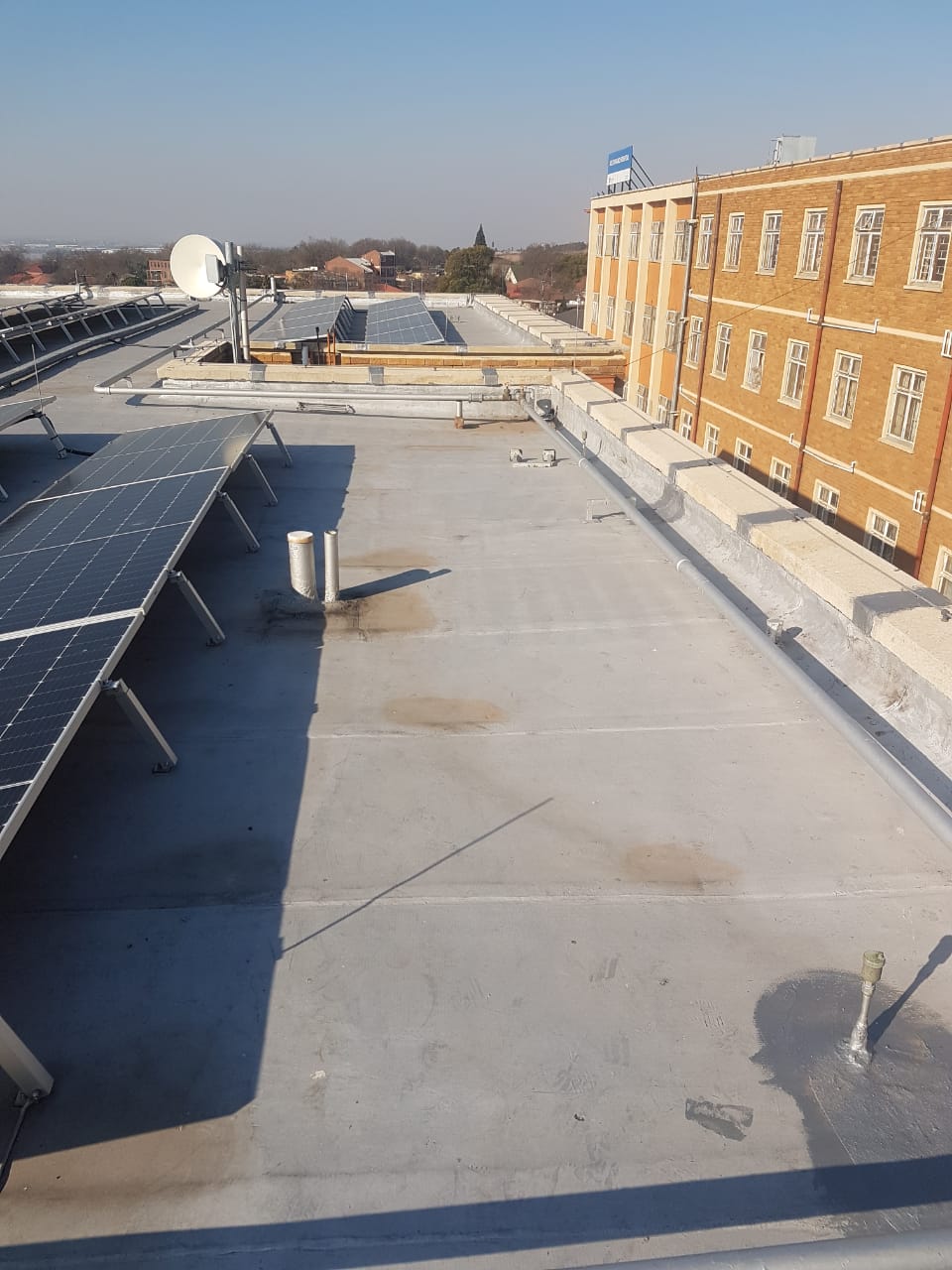

Cleaning
- Sweeping and Cleaning
- Power wash roof
Start date
25 – 29 June 2025
Comments
Washing and Cleaning
Date completed
Repairs

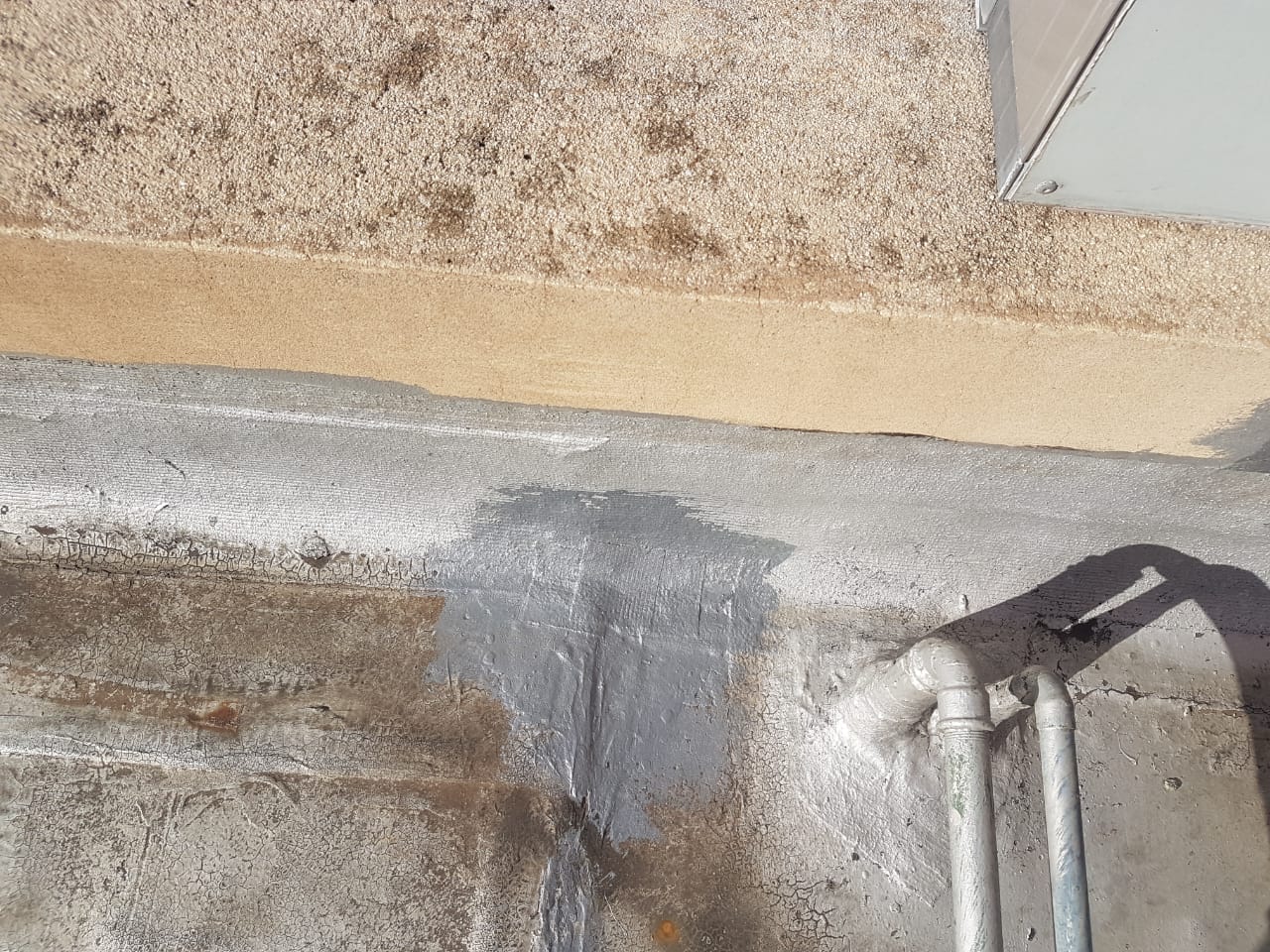

- Check, repair cracks, tears and breaks of torchon
Start date
25 June 2025
Â
Comments
Repairs
Date completed
1st Solar panel testing
- Audit and record solar panel output before cleaning and sealing
Start date
07 July 2025
Comments
Access to container granted by Cynthia
554.1 v
131.1A
72.3kw
Date completed
07 July 2025

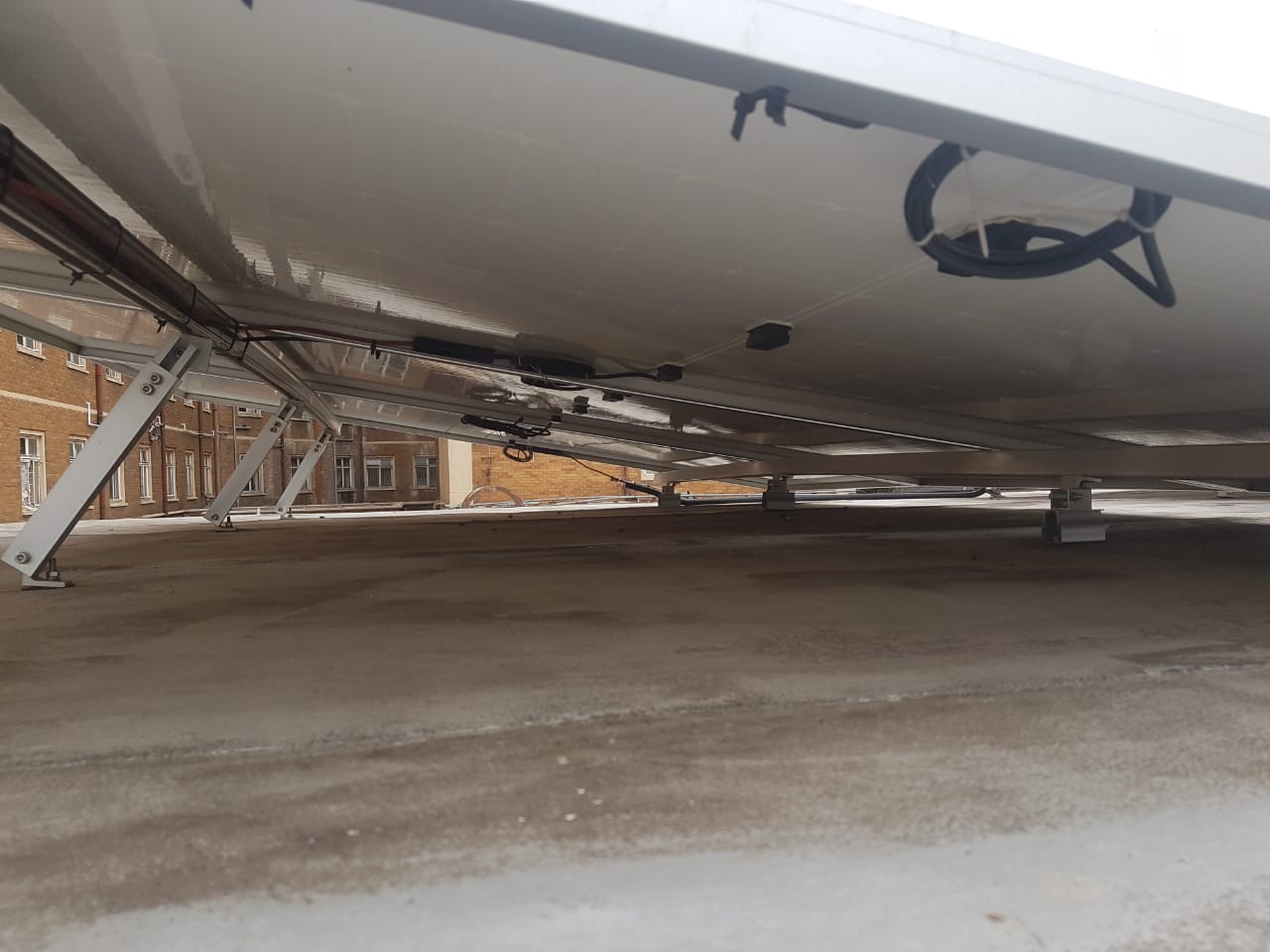

Solar panel cleaning
- Washing of panels
Start date
02 July 2025
Comments
Cables tidy up for roof surface washing
Date completed
2nd Solar panel testing
- Audit and record solar panel output after cleaning and sealing
Start date
14 July 2025
Comments
Access to container granted by Cynthia
554.1 v
88.7A
43.6kw
Date completed
14 July 2025
Sealing of roof
- 1st coat of sealer to be sprayed on
- 2nd coat of sealer to be sprayed on
- Hand painting of sealer in difficult to reach areas
Start date
09Â July 2025
Comments

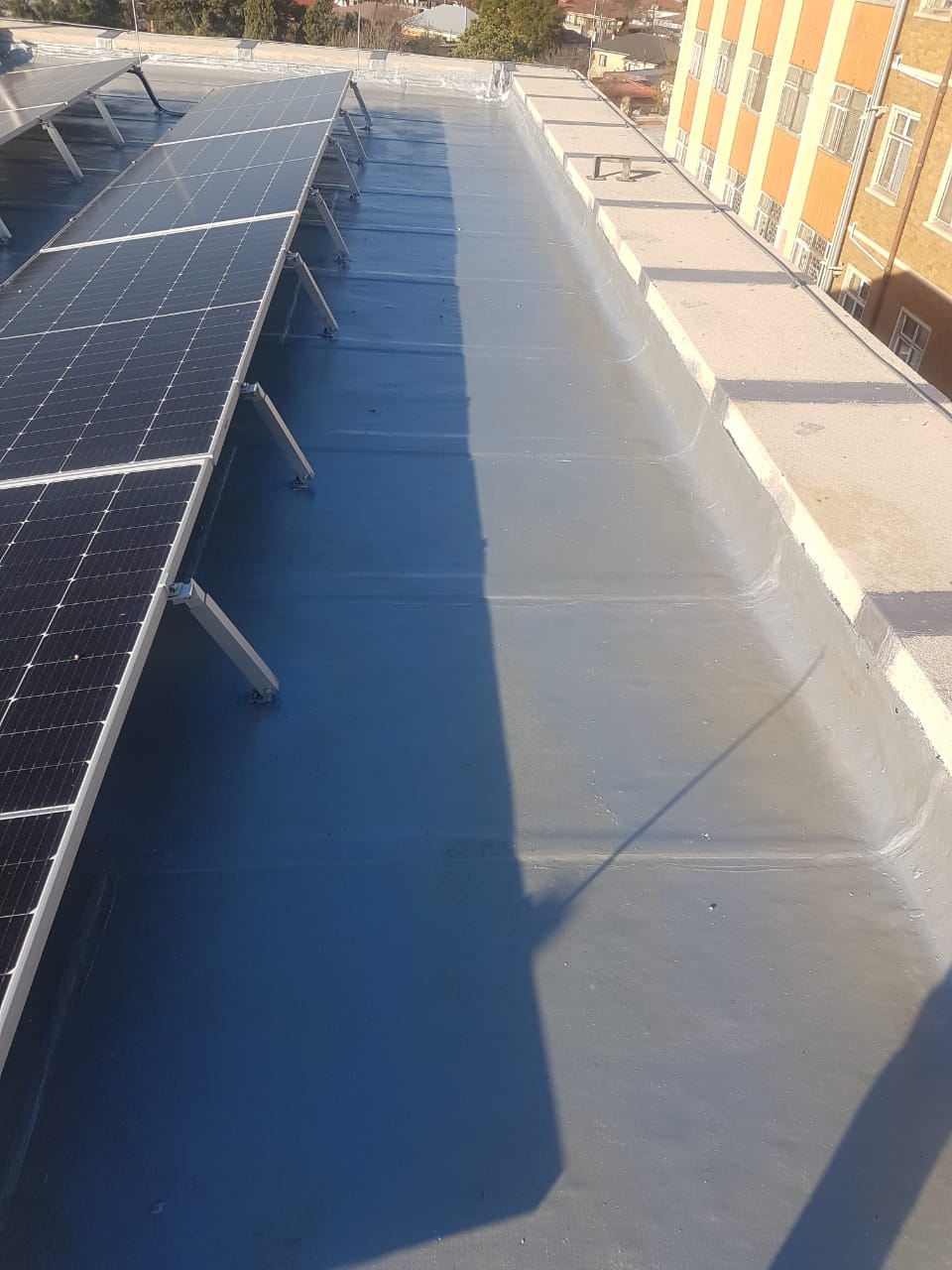

1st Coat

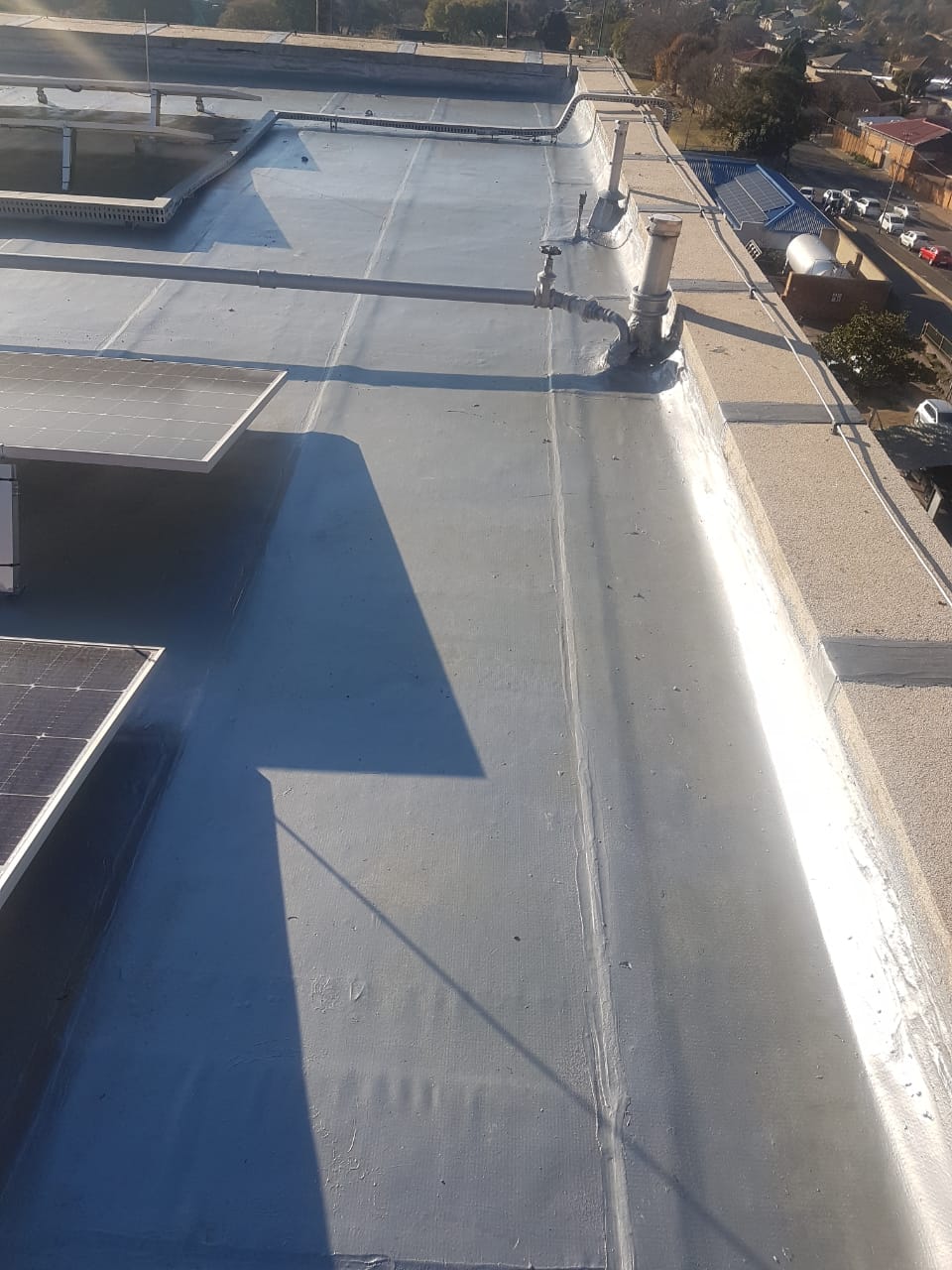

2nd Coat
Date completed
Other findings
- Old Paint on solar Panels prior to us starting
- Damages to solar panels prior to us starting

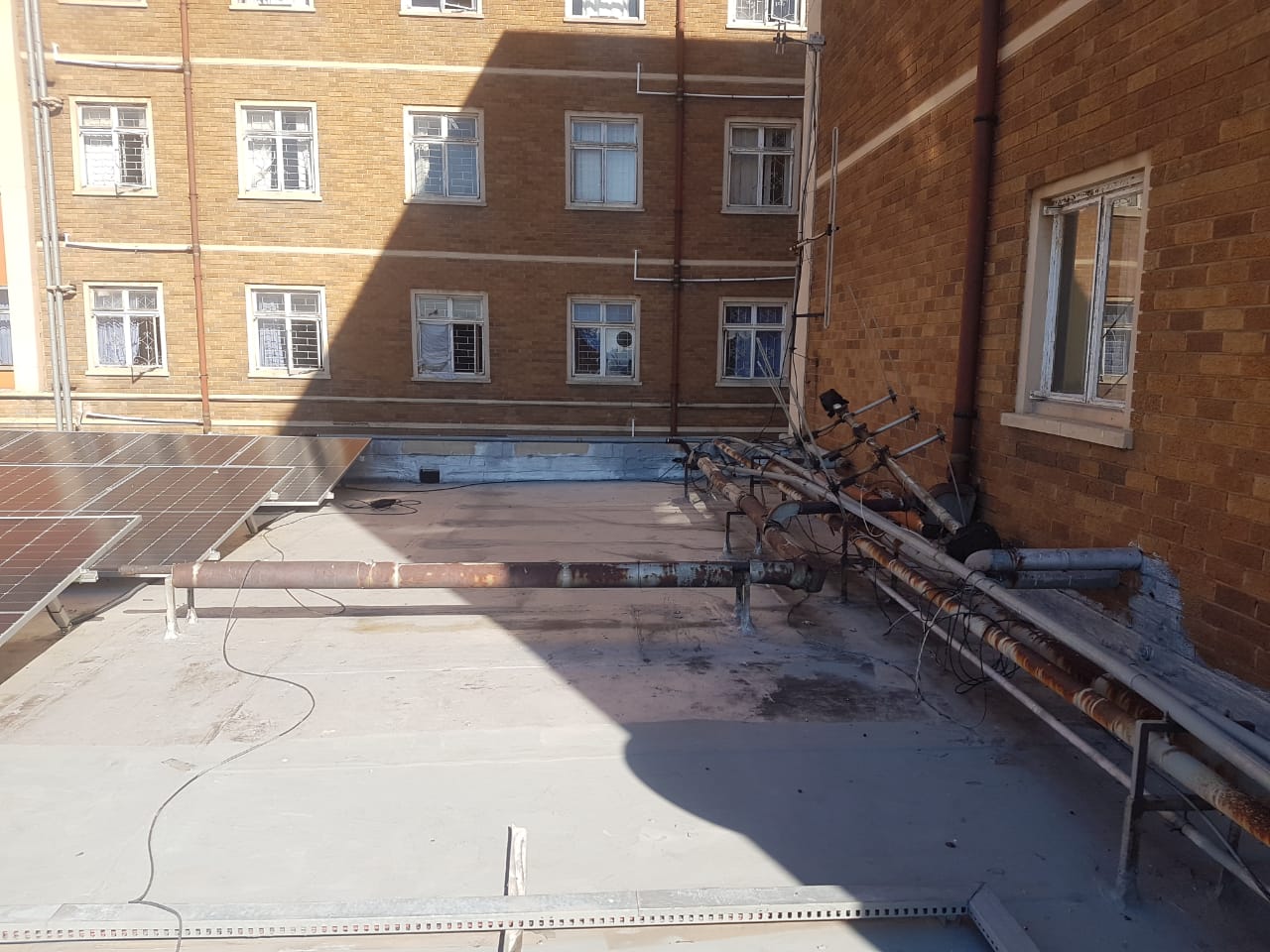

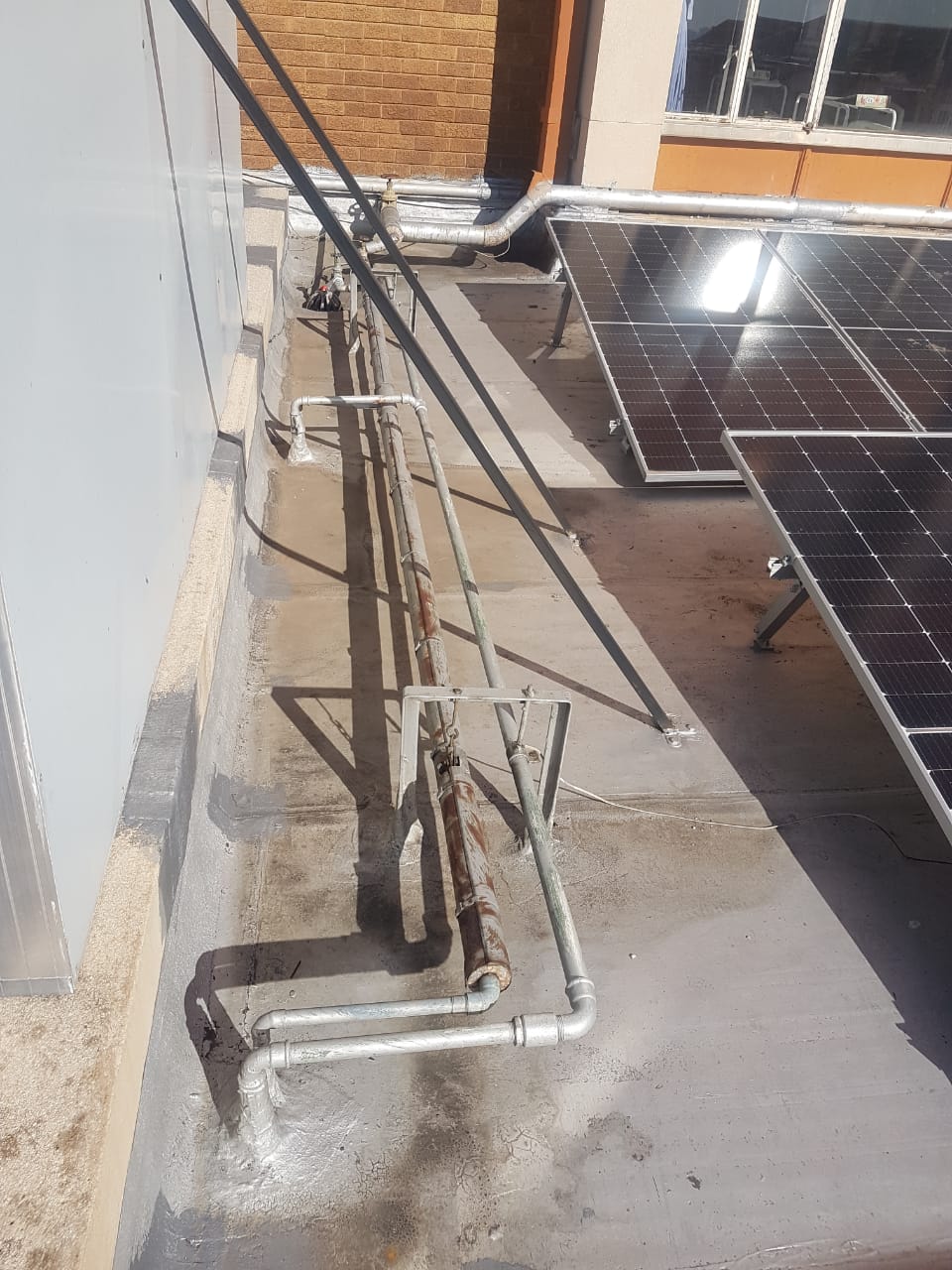

- Cables not secured to frams
